The WA Government has proposed construction of a new desalination plant to be delivered by WA Water Corporation. The desalination plant will be located in Alkimos, north of Perth and adjacent to an existing wastewater treatment plant. The full scope of the project would be delivered in two stages, with only the 50 billion-litre Stage One currently confirmed.
Included in the scope of Stage One is:
- desalination plant with a 50 billion litre annual capacity
- groundwater treatment plant
- ocean intake pipeline below the seabed
- an ocean discharge pipeline below the seabed to transport brine from the plant
- a 34-kilometre pipeline to transport drinking water to Wanneroo Reservoir
WA Water Corporation is expected to secure a Power Purchase Agreement for up to 400 megawatts of renewable wind energy to power the Alkimos Seatwater Desalination Plant, as well as its existing desalination plant at Kwinana and Binningup.
Key Dates
| Jun 2022 | Project Announcement |
| Dec 2023 | Preferred Bidder Selection - Stage One Design and Construction |
| Apr 2024 | Preferred Bidder Selection - Operations |
| Oct 2024 | Construction Commencement |
| 2028 | Expected construction completion: Stage One |
Funding contributions
| User charges |
Procurement
| Procuring Agency: | WA Water Corporation |
| Successful Tenderer: | ACCIONA and Jacobs |
| Procurement note: | The consortium was previously known as the Northern Water Partnership (NWP). |
| Related contracts: |
PROJECT HISTORY
| May 2019 | The project was referred to the Western Australian EPA. |
| Jun 2019 | The Western Australian EPA announced an environmental assessment would be required for the project. |
| May 2022 | The 2022-23 WA Budget announced WA Water Corporation would retain its forecast FY2021-22 dividend payment of $1.4 billion in the 2021-22 Budget to instead contribute to funding a new desalination plant. |
| Jun 2022 | The WA Government announced the project and confirmed the new desalination plant would be located in Alkimos, with a proposed scope of 100-billion-litres per year. |
| Sep 2022 | An Environmental Review Document was uploaded to the Western Australian EPA for public consultation, closing 25 October. |
| Nov 2022 | Steel Mains was awarded the $58 million contract to manufacture the steel pipes for the first 6.5 kilometres of the Alkimos to Wanneroo desalination pipeline project. |
| May 2023 | The WA Government allocated $65 million towards early enabling works in the 2023-24 Budget. |
| Aug 2023 | The project received development approval from the Western Australian EPA. |
| Nov 2023 | The project received environmental and planning approvals from the Federal Department of Climate Change, Energy, the Environment and Water. |
| Dec 2023 | The WA Government confirmed $2.8 billion in funding to the project. |
| Dec 2023 | A consortium of ACCIONA Agua Australia, ACCIONA Construction and Jacobs Group Australia was selected as the preferred proponent to design, build and operate Stage One of the Desalination Plant. Subject to further negotiations, the consortium will form an alliance to be known as the Northern Water Partnership (NWP). |
| Apr 2024 | The WA Government announced that the desalination plant will be operated by Northern Water Partnership alongside WA Water Corporation, together forming Alkimos Seawater Alliance. The operations contract will be for a minimum of 10 years from the project's completion. |
| May 2024 | The 2024-25 WA Budget announced WA Water Corporation would retain its forecast FY2023-24 dividend payment of $766 million to instead contribute to its asset investment program, including $656 million for the Desalination Plant. WA Water Corporation allocated $597 million towards the project's program of work in FY2024-25. |

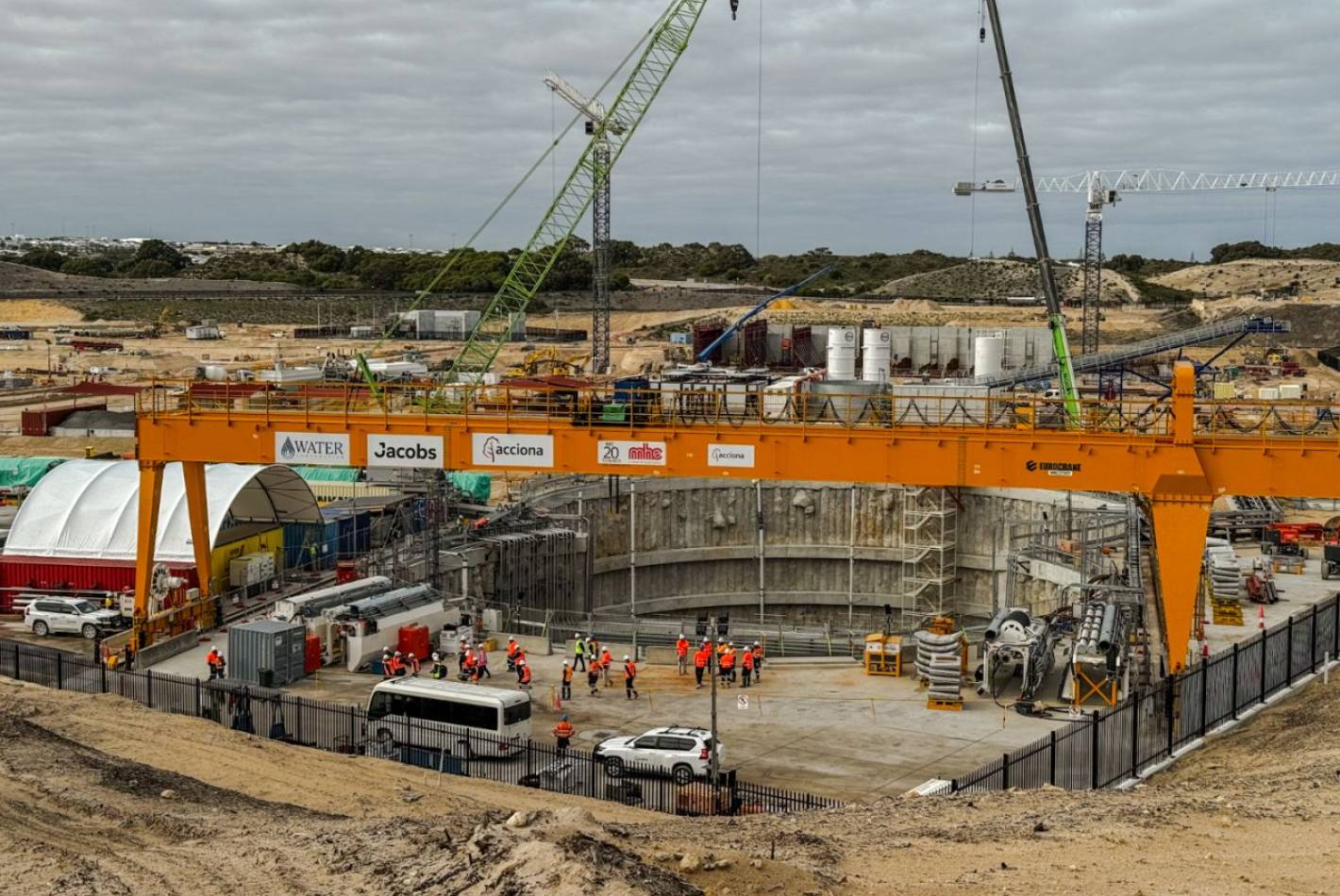

| 2024 | Construction commenced on the Alkimos Desalination Plant. |
| Dec 2024 | The WA Government announced the commencement of the Alkimos to Wanneroo desalination pipeline project. The 33.5-kilometre underground pipeline will run from Alkimos to Wannerroo and transfer desalinated water into the Integrated Water Supply Scheme. The first 6.5 kilometres has commenced construction by Steel Mains. The Government also announced that a consortium of Georgiou Group and DM Drainage and Constructions has been named the preferred proponent to design, build and commission the remaining 27.5 kilometres of the pipeline. The second stage is expected to commence in 2025 and be complete in late 2027. |
| Oct 2025 | Water Corporation WA announced Stage Two of the Alkimos to Wanneroo desalination pipeline, part of the broader Alkimos Desalination Plant, had commenced construction. |
| Jun 2026 | The Alkimos Seawater Alliance announced a scope change, with a groundwater treatment plant to be included in the design of the broader seawater desalination plant. |
