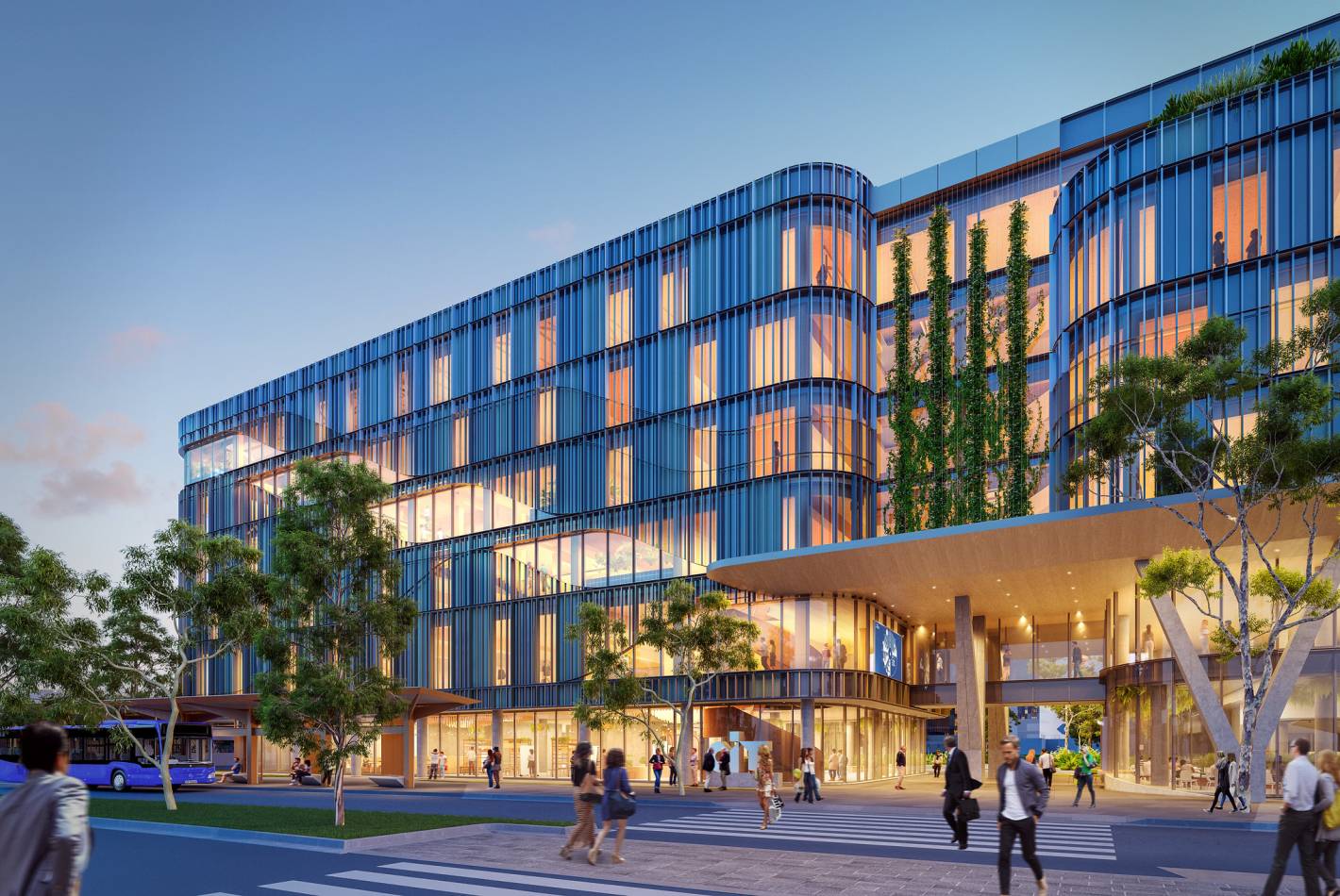

The new Canberra Institute of Technology (CIT) campus in Woden will service around 6,500 students and will focus on IT, cyber security, hospitality and business faculties. The new campus will replace CIT’s Reid Campus and will be built at the site of the existing Woden bus interchange.
The new CIT campus is proposed to include:
- smart classrooms
- cyber training and digital learning spaces
- a training restaurant with a commercial kitchen
- collaboration and group-work learning spaces
- function rooms, activated common areas and greenspace
- incubator hubs and spaces for collaboration with industry and local businesses
- a pedestrian boulevard linking the interchange to Woden Town Square
- a new Bowes and Bradley Street local shared zone
- ‘smart campus’ technology which would link the campus with custom digital learning management systems, and
- youth foyer housing to support vulnerable young people undertaking training or study.
The design and construction works will be undertaken by Lendlease, in a combined contract which includes both the Woden CIT Campus and a new public transport interchange at Woden.
Key Dates
| May 2022 | Preferred Bidder Selection |
| May 2022 | Contract Award |
| Aug 2023 | Construction Commencement |
| Jun 2025 | Construction Completion |
Funding contributions
| ACT Government |
Procurement
| Procuring Agency: | ACT Government |
| Successful Tenderer: | Lendlease Building |
| Related contracts: |
PROJECT HISTORY
| Aug 2020 | The project was approved by the ACT Government. |
| May 2022 | The ACT Government announced Lendlease Building as the preferred contractor for the design and construction of the new campus in Woden. |
| May 2022 | The ACT Government awarded the contract to Lendlease Building. |
| Aug 2022 | The ACT Government released the project's external, internal, and map concept designs for public consultation. |
| Feb 2023 | Demolition works commence. |
| Aug 2023 | The Development Application for the project was approved, and construction commenced on the project. |
| Jun 2024 | The 2024-25 ACT Budget allocated $154 million over two years for the new campus in Woden and the accompanying bus interchange. |
| May 2025 | The ACT Government announced that the project is expected to be completed in July. |
| Jun 2025 | Main works complete on the project, opening in July 2025. |
Sector
Social
Procurement approach
Traditional Procurement |
Location
Australian Capital Territory |
