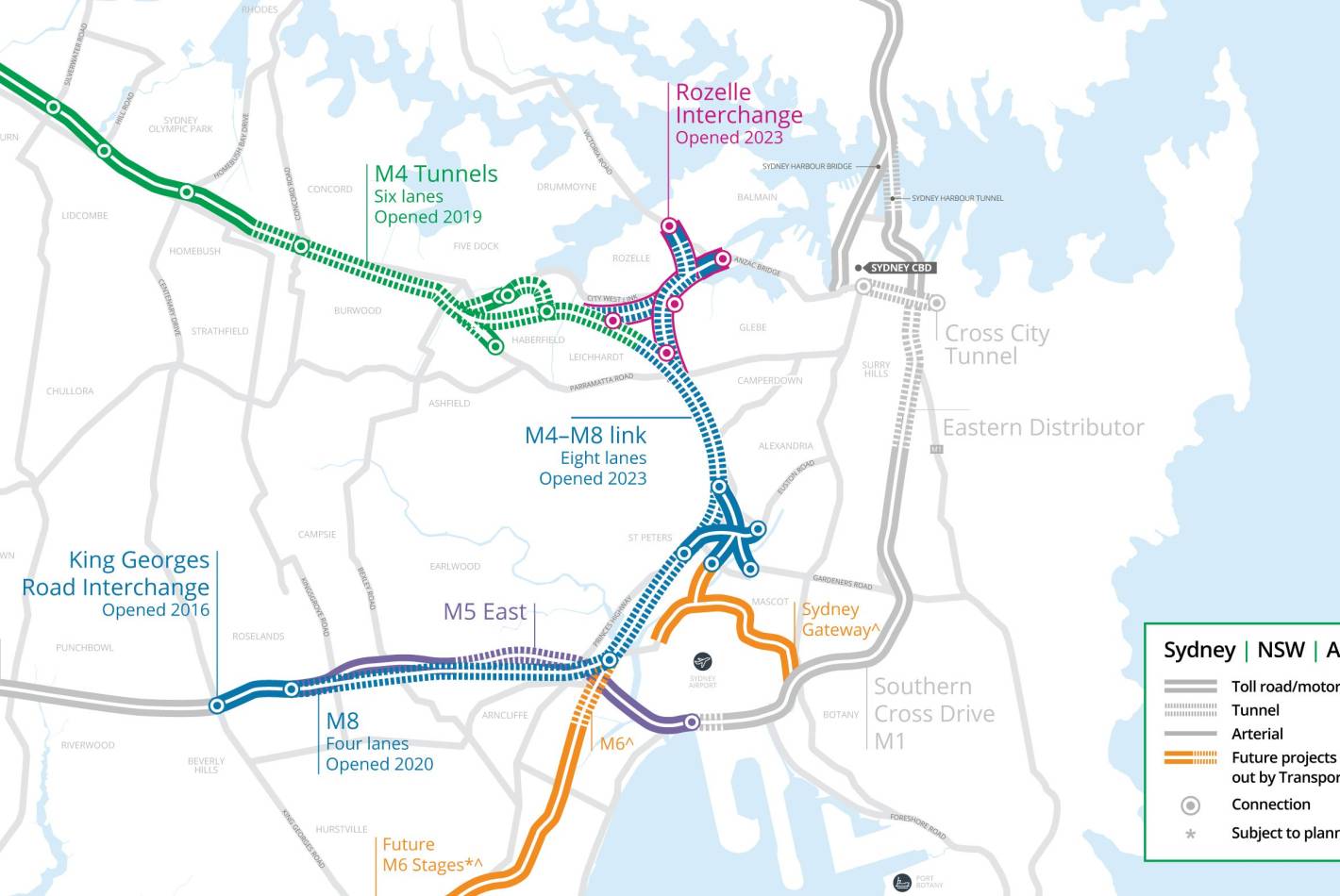

The WestConnex project will deliver 33 kilometres of new road connections to complete Sydney's orbital motorway network. WestConnex is being delivered across three stages, including:
- Stage 1A: widening the M4 Motorway
- Stage 1B: extending the M4 (M4 East) from Homebush to Haberfield via Concord with 5.5 kilometres of new three-lane tunnel
- Stage Two: an extension of the M5 Motorway to St Peters
- Stage 3A: a new M4-M5 link between Haberfield and St Peters, and
- Stage 3B: a new interchange at Rozelle.
The project is being funded through a combination of State Government contributions, a Commonwealth concessional loan, and a distance-based toll.
Key Dates
Sep 2012 | Project Announcement |
Mar 2015 | Construction Commencement |
Nov 2023 | Construction Completion |
Funding contributions
User charges | |
Federal Government | |
The Westconnex project will be funded by user charges through three tolling concessions:
|
Financing
Equity Finance: | Sydney Transport Partners |
Debt Finance: | Federal Government |
Sydney Transport Partners, a consortium comprising Transurban, AustralianSuper, Canada Pension Plan Investment Board and Tawreed, aquired 100 per cent of WestConnex through two separate equity sales from the NSW Government, for a combined total of $20.4 billion. |
Procurement
Procuring Agency: | WestConnex Delivery Authority / Sydney Motor Corporation. |
Related contracts: |
PROJECT HISTORY
Sep 2012 | The WestConnex concept was first developed by Infrastructure NSW as part of its 2012 State Infrastructure Strategy. INSW |
Oct 2012 | INSW released a Concept Paper, estimating the project's total cost at $10 billion, with 7.5 billion to be funded through user charges and the remaining $2.5 billion funded through Federal and NSW Government contributions. |
Sep 2013 | The WestConnex Business Case Executive Summary was published, estimating a total estimated cost increase to between $11 billion and $11.5 billion. The NSW Government was expected to provide $1.8 billion in funding, with the Federal Government committing $1.5 billion in funding. |
Oct 2013 | The NSW Government established WestConnex Delivery Authority to oversee the procurement and delivery of the project. |
May 2014 | The 2014-15 Federal Budget allocated $1.5 billion in funding toward the project and a concessional loan of up to $2 billion to accelerate delivery of Stage Two. |
Aug 2014 | The NSW Government established the Sydney Motorway Corporation, a Government-owned corporation to lead the financing of WestConnex. |
Nov 2014 | Infrastructure NSW released a revised total project costs to $14.9 billion, including $1.8 billion for the northern and southern extensions. The Federal Government also announced it would provide a $2 billion concessional loan to accelerate the delivery of Stage Two. |
Dec 2014 | The NSW Government announced the Rizzani De Eccher Leighton Joint Venture had been awarded the contract to design and construct the M4 Widening. |
Mar 2015 | Construction commenced on Stage One: New M4. |
May 2015 | Fulton Hogan was awarded the contract to deliver the the King Georges Road Interchange upgrade. |
Jun 2015 | The 2015-16 NSW Budget announced the project's total estimated cost had increased to $15.4 billion. |
Sep 2015 | A consortium comprising Leighton, Dragados and Samsung was announced the preferred tenderer for the $5 billion WestConnex Stage Two. |
Oct 2015 | The WestConnex Delivery Authority was merged into the NSW Government agency Sydney Motorway Corporation. |
Nov 2016 | Construction commenced on Stage Two: New M5. |
Aug 2018 | The NSW Government sold 51 per cent of the NSW Government’s equity stake in Sydney Motorway Corporation to the Sydney Transport Partners consortium for $9.3 billion. The consortium comprises Transurban, AustralianSuper, Canada Pension Plan Investment Board and Tawreed. |
Sep 2018 | The NSW Government's 51 per cent equity sale to Sydney Transport Partners reached financial close. |
Jul 2019 | Construction was completed on Stage One: New M4. |
Jul 2020 | Construction was completed on Stage Two: New M5. |
Sep 2021 | The NSW Government sold its remaining 49 per cent stake in the the Sydney Motorway Corporation to Sydney Transport Partners for $11.1 billion. |
Feb 2023 | Construction was completed on Stage 3A: M4-M5 Link. |
Nov 2023 | Construction was completed on Stage 3B: Rozelle Interchange. |
